Installed by our team in about 2.5 hours.
On the floor you already have: the parts lock together, with no welding, no anchors and no damage to the floor. UK installation is included in the price.
£9,750 + VAT
£12,500 + VAT
Delivered and installed by our team
Send a photo of your floor and we reply with a free placement plan within one working day.
- ≈2.5 h
- installation
- 40 min
- dismantling
- 0
- anchors · welds
- 11
- panels · 66 wheels
- 4
- motors · 24 V
Six part groups. All numbered.
Hub and ring
Tapered-bearing hub, 8 arms, inner and outer arc plates.
4 drive stations
24 V motor, drive wheel and stop — bolted to the ring in a cross.
11 triangular panels
Nine male–female, one male–male, one female–female that closes the ring. Six wheels under each.
Edge ramps
All ramps are reinforced; the car drives on and off from any side except over the four motor ramps.
Control panel and remotes
Wall panel on a standard 13 A socket: LCD, speed and direction, emergency stop. 2 Bluetooth remotes, 8 m range.
Tools needed
Hex key, screwdriver, 13 mm spanner. That is all.
From the hub to the ramps, inside out.





1. The spot
A flat 6 × 6 m area; at least 3 m from the hub to the wall. Concrete, epoxy, tile or marble — no anchors, no excavation.
Check
All parts are checked against the inventory.
Top view · to scale
Side elevation · to scale
2. Hub and ring
The bearing seats in the hub. Eight arms bolt to the hub, the arc plates to the arms; the ring is complete.
Check
The hub plate must sit without play.
3. Motors
Four drive stations bolt to the ring in a cross (4 × 90°). Wheels are aligned with the ring; stops are tightened with the 13 mm spanner.
Check
Every wheel must fully touch the ring.
4. Panels

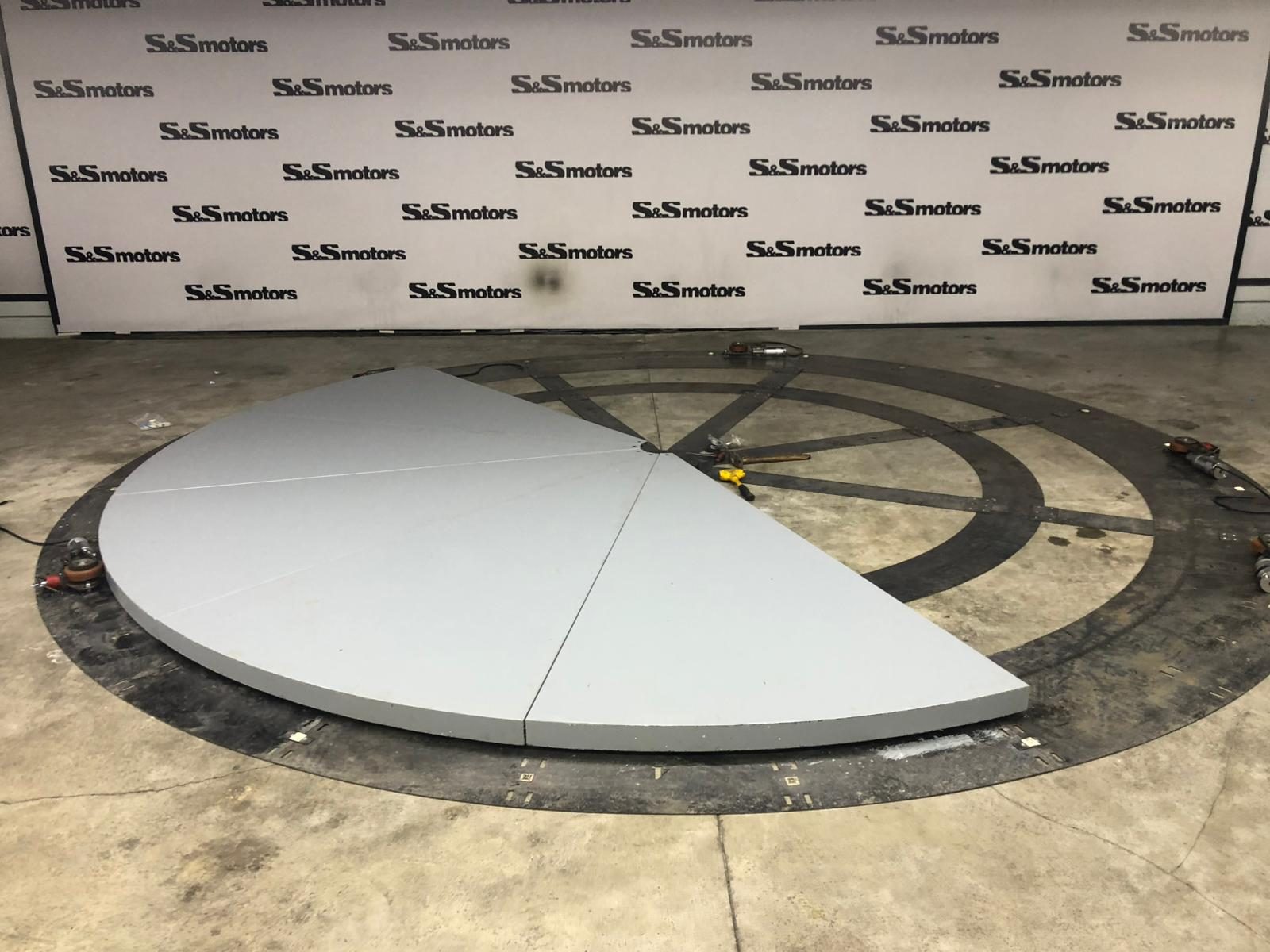

Eleven triangular panels lock together from the hub outwards: male–female panels first, the female–female one closes the ring. Hub cover last.
Check
No height difference between panels.
5. Ramps and power
The four motor ramps go over the motors, the other ramps around the rest; all ramps are reinforced. Motors plug into the control panel, the panel into a standard 13 A socket; remotes are paired. The first turn is done empty.
Check
Red to plus, blue to minus; reversed polarity turns the wheel the wrong way.
Down in 40 minutes, moved in the same crate.
The same steps in reverse. When the showroom changes, the platform comes with you; the floor stays as it was.

Our team installs it for you.
Our installers on site
Our team assembles it with hand tools in about 2.5 hours and shows your staff how to run it.
Handover and support
Before we leave we walk your team through the panel and remotes; afterwards, questions are answered within one working day.
Illustrated manual
Every step with photos and checkpoints. It ships in the crate and can be downloaded as a PDF.
Your showroom is next.
Buy once, use for decades. Create your order or message us on WhatsApp.
